Production scheduling

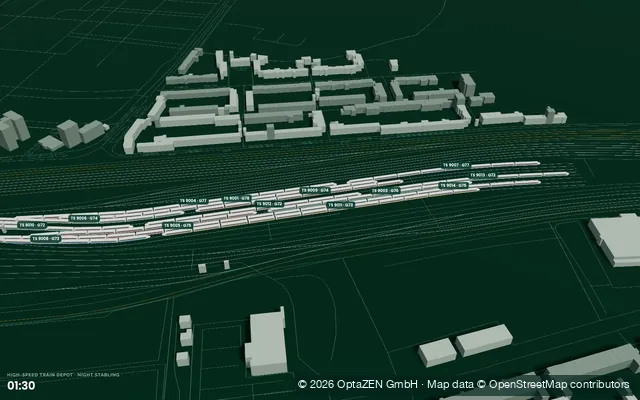

Night maintenance and shunting in a rail depot

Which train goes to which maintenance track and in which order, and how does the shunting crew get it there?

Result in this example, compared with “arrival order”: shunting conflicts 0 min instead of 30 min, siding overflow 0 min instead of 77 min.

Rail operatorsRolling stock maintenanceInfrastructure

Drag to rotate, scroll or pinch to zoom. The schedule below plays the plan; hover a bar for details.

The planning question

High-speed train sets come in from service in the evening and must be back on the timetable in the morning. Maintenance orders (wash, inspections, drop-pit work, wheel re-profiling) come from the maintenance system. One shunting crew moves the trains through a switch ladder; three sidings buffer trains between jobs.

How we plan it

The model plans maintenance and shunting together, because a free wheel lathe only helps if the train can be moved there in time.

What the plan shows

KPIOptimized planComparison: arrival order
late trains11
late minutes37 +352
shunting conflicts (min)0 −3030
siding overflow (min)0 −7777

Decisions

  • maintenance track and start time per work order
  • order of the work per train
  • shunting moves through the switch ladder

Constraints

  • track equipment (wash, pit, drop pit, wheel lathe)
  • trains cannot turn between tracks: reverse via a head shunt
  • one shunting crew, conflict-free moves
  • siding capacity
  • departure time in the morning

Objective

trains back in service with as little delay as possible, no shunting conflicts, no siding overflow

Questions

Where do the work orders come from?

Typically from SAP PM or another maintenance system; completed orders are reported back.

What if a job takes longer?

The plan is updated and the following moves and jobs are re-planned.

Are all trains on time in this plan?

No. One train leaves 37 minutes late. The comparison shows only 2 minutes of delay, but its shunting moves overlap for 30 minutes and its sidings are overfilled for 77 minutes, so the night could not run that way. The plan has neither conflict.

The first step
